There is a simple principle worth building a tracking habit around: the worst time to find out an order is late is the day the factory originally promised to finish it. By then freight is booked, customers have been told, and stock plans are already built on a date that no longer exists.
Tracking is not about sending more messages. It is about agreeing in advance which checkpoints will be confirmed, so that a slip at week two surfaces at week two rather than at week six. A factory genuinely on schedule finds this easy. One that resists specific milestone confirmation is telling you something before any delay appears.

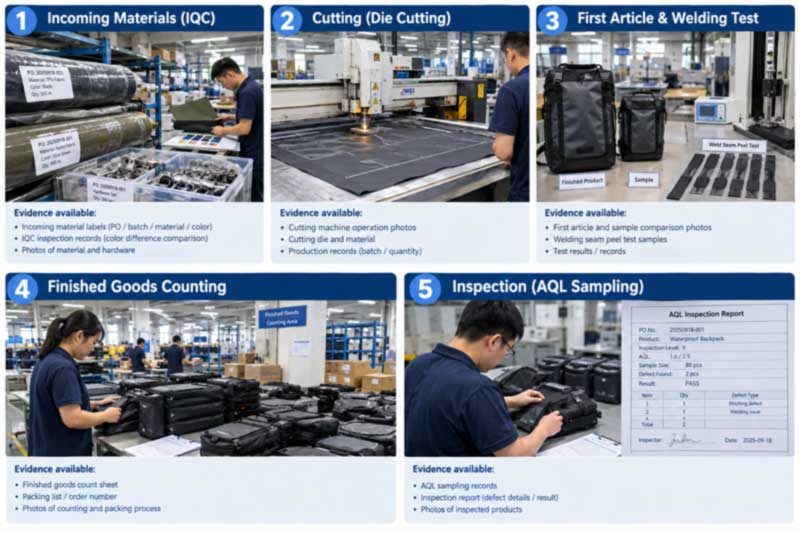

Rather than asking when goods will ship, follow progress at each stage. On a waterproof bag order the meaningful checkpoints are:
| Milestone | What it confirms | Evidence to request |
|---|---|---|
| Materials arrived and inspected | Fabric, zippers, hardware in house and passing IQC | Photos of the rolls and hardware with the order reference; confirmation of shade against the approved standard |
| Cutting started | Panels being cut to the approved pattern | Line photos; confirmation that pattern version matches the approved sample |
| First article approved | The first production unit matches the gold sample | Photos or a shipped first-article unit; weld peel test result from run start |
| Production complete | Quantity finished, before packing | Count confirmation and in-line QC records |
| Inspection passed | Goods verified against the agreed AQL and tests | Inspection report — the document the balance payment is tied to |
The value of naming these at order confirmation rather than mid-production is that each one has a date attached. A missed milestone then becomes visible immediately rather than being absorbed silently into the schedule.

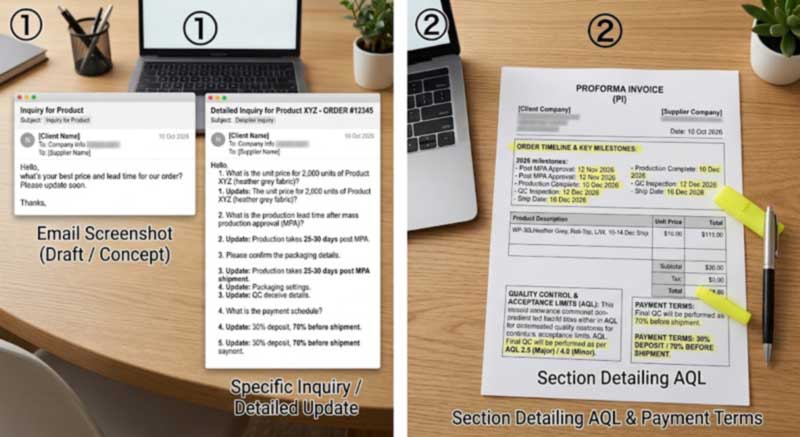

This is the single most useful habit a buyer can adopt, and it costs nothing. Compare:
Other questions with the same property: how many units are cut, how many welded, how many assembled, what date will the first article be ready, which date is the inspection booked for. Vague questions get vague answers; specific questions expose problems early enough to solve them.
A related signal worth watching: updates that become less specific over time. A supplier who was giving unit counts and now says "everything is on track" has usually hit a problem it is trying to recover from before telling you. That shift in language is often the earliest warning available.
Delays in this category concentrate in predictable places, and knowing them tells you what to check:
Tracking works better when the terms are agreed at the start. Worth including in the purchase order or pro forma invoice:
For context on what is happening during those weeks, a waterproof bag moves through a fixed sequence:
The full technical sequence is set out in the guide to the manufacturing process from cutting to RF welding.
Factory updates are useful but they are self-reported. Where an order is large or date-critical, an independent check converts a claim into a fact — a during-production inspection at roughly 20–30% completion catches fundamental problems while the run can still be corrected, and a final inspection before shipment verifies the finished goods.
Buyers are welcome to appoint their own inspector or a third party such as SGS or QIMA at either site. The full customer inspection procedure — unboxing, vacuum extraction, a 24-hour static rest, and air-leak determination — can be witnessed end to end. Standards and defect classifications are set out in the quality control standards for waterproof production, and how to arrange an on-site visit in the guide to factory audits.
One habit that separates buyers who improve from those who repeat the same problems: a short post-order review once the goods have shipped. Walk the timeline milestone by milestone and ask where problems occurred, what the root cause was, how effective the fix was, and how it could be prevented entirely next time.
On a repeat programme this feeds directly into the next order — a component that caused a delay gets ordered earlier, a specification ambiguity that caused rework gets written into the standard pack, and the schedule gets adjusted to reflect what actually happened rather than what was planned. Keeping the fifth order as good as the first is covered in the guide to reorder consistency.
